CPM is applied to equipment maintenance

Source: Shangpin China | Type: website encyclopedia | Time: October 31, 2014
Equipment is a component element of productivity and the material and technical basis of modern production. Like a Website Design There is no good drawing equipment, and no effective design drawings will be produced. The status of equipment and the level of investment costs have a direct impact on the normal production of enterprises, the output, quality and cost of products. Network planning technology is not only widely used to arrange production plan and production technology preparation plan, but also widely used to arrange equipment repair plan. When applying network planning technology to arrange repair plans, it is necessary to first understand what repair items, work sequences and their relationships are; Second, the downtime for repair should be calculated according to the complexity coefficient of equipment repair, labor quota, and the number of repair personnel; Third, we should understand and improve the labor organization of repair operations; Fourth, understand and make technical preparation and spare parts supply before repair.

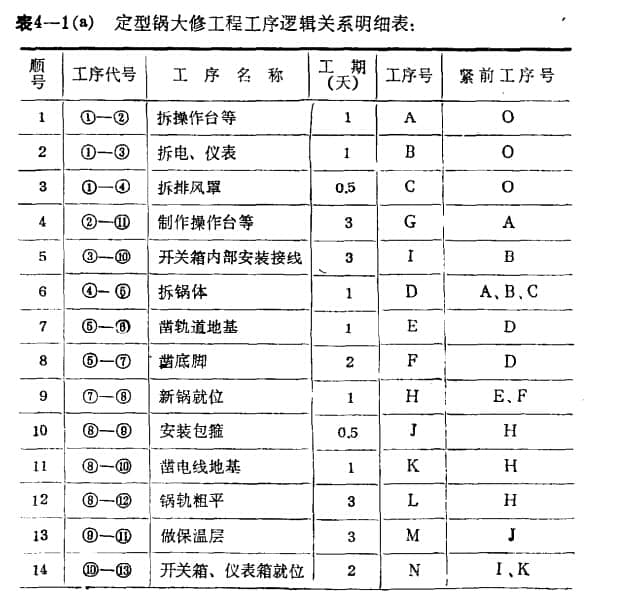

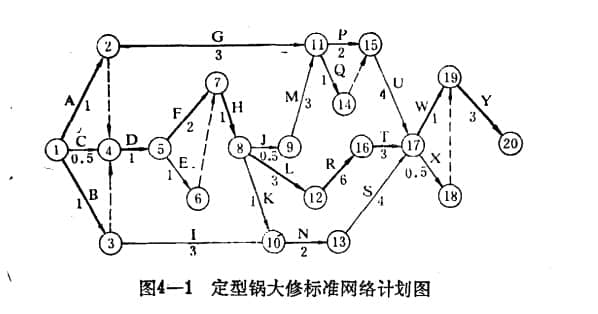

After all preparations are completed, the network plan can be prepared to arrange the repair progress. If the results of the initial arrangement cannot ensure that the repair task can be completed within the specified time, it is necessary to analyze and study the critical path, adopt parallel operations, improve labor organization, shorten repair downtime and other measures. While ensuring that the repair workers are fully loaded, it is also necessary to ensure that the repair quality and repair cost do not exceed the quota. For example, the original plan for the overhaul project of a certain nylon mill's textile setting pot was to ensure that two sets of the pot could be completed, and the overhaul time was one month. After adopting the network planning technology, the overhaul project of three sets of sizing pots was completed at the same time, and the overhaul period was shortened to 21 days, with significant economic benefits. In addition, the standard network plan for overhaul of finalizing boiler has been prepared (see Figure 4-1 for details). Logic relation list of sizing pot overhaul project (see Table 4-1 (a) for details).

The application of CPM in power plant boiler overhaul is introduced below.
With the development of electric power industry, the number of high parameter and large capacity units is increasing, the scale of overhaul is becoming larger and larger, the amount of overhaul work is large, the construction technology is complex, and the duration is long, which brings many special details and problems. Therefore, in the overhaul construction, only the overall arrangement of the overhaul process items, tasks, equipment and personnel can ensure the smooth progress of the project. In recent years, power plants around the country have begun to apply the advanced technology of network planning in overhaul management, which has achieved obvious results and accumulated some experience. It generally adopts the positive type of the overall planning method, namely the critical path method, to prepare the construction schedule. This method enables us to grasp the interrelationship between the tasks that must be completed in the plan, find out the main contradiction lines and main contradiction links (i.e. key processes) that control the maintenance progress in the intricate construction network diagram, and calculate the maneuver time of each process on the non critical path, so as to find a balanced dynamic force plate, Effectively control and ensure the completion of key processes, so as to ensure quality and quantity, shorten the construction period and reduce costs.

The application of CPM in the overhaul of boiler 6 in a power plant is listed below. Boiler 6 is a domestic 130T/H liquid slag extractor. In this overhaul, in addition to the standard overhaul, a lot of special items with workload are added. For example, replacing the superheater tubes, replacing more than 50% of the economizer tubes, replacing and reinstalling all the anti-wear sleeves of the air preheater, replacing some water-cooled wall tubes at the bottom of the furnace and repairing the bottom of the furnace, there are still many changes to be made. According to the maintenance force in the plant, the superior approved the overhaul period as two months. Faced with the situation of maximum work, limited maintenance personnel, and short overhaul period, the plant conducted careful research and determined to apply the critical path method in construction management. For the whole overhaul project, the man hour quota was estimated and the network diagram was prepared in detail and comprehensively. According to the network diagram, coordinate and cooperate in the construction, and comprehensively and reasonably arrange the project, manpower and material resources. The overhaul task was successfully completed by grasping the main contradiction, taking time on the critical path, and saving manpower and material resources on the non critical path. It has achieved remarkable results in terms of quality and quantity, consumption reduction and construction period shortening. The calculation period of the network diagram is five days shorter than the specified period, and in the actual maintenance, the period is five days earlier than the calculation value of the network diagram.
Source Statement: This article is original or edited by Shangpin China's editors. If it needs to be reproduced, please indicate that it is from Shangpin China. The above contents (including pictures and words) are from the Internet. If there is any infringement, please contact us in time (010-60259772).
TAG label:

What if your website can increase the number of conversions and improve customer satisfaction?

Make an appointment with a professional consultant to communicate!

* Shangpin professional consultant will contact you as soon as possible

Disclaimer

Thank you very much for visiting our website. Please read all the terms of this statement carefully before you use this website.

1. Part of the content of this site comes from the network, and the copyright of some articles and pictures involved belongs to the original author. The reprint of this site is for everyone to learn and exchange, and should not be used for any commercial activities.

2. This website does not assume any form of loss or injury caused by users to themselves and others due to the use of these resources.

3. For issues not covered in this statement, please refer to relevant national laws and regulations. In case of conflict between this statement and national laws and regulations, the national laws and regulations shall prevail.

4. If it infringes your legitimate rights and interests, please contact us in time, and we will delete the relevant content at the first time!

Contact: 010-60259772
E-mail: [email protected]

Communicate with professional consultants now!

  • National Service Hotline

    400-700-4979

  • Beijing Service Hotline

    010-60259772

Please be assured to fill in the information protection
Online consultation

Disclaimer

Thank you very much for visiting our website. Please read all the terms of this statement carefully before you use this website.

1. Part of the content of this site comes from the network, and the copyright of some articles and pictures involved belongs to the original author. The reprint of this site is for everyone to learn and exchange, and should not be used for any commercial activities.

2. This website does not assume any form of loss or injury caused by users to themselves and others due to the use of these resources.

3. For issues not covered in this statement, please refer to relevant national laws and regulations. In case of conflict between this statement and national laws and regulations, the national laws and regulations shall prevail.

4. If it infringes your legitimate rights and interests, please contact us in time, and we will delete the relevant content at the first time!

Contact: 010-60259772
E-mail: [email protected]
